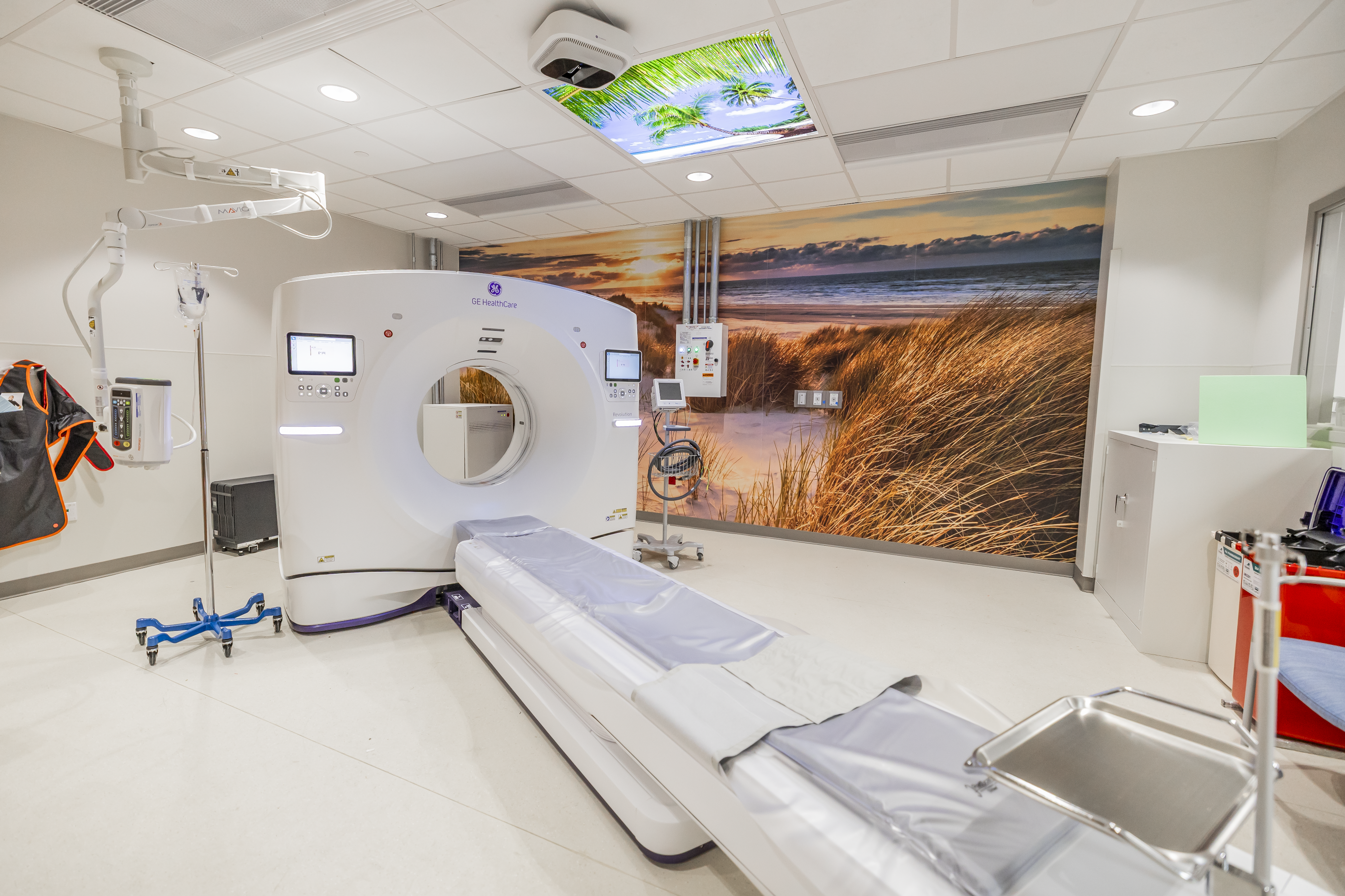

CT machine with beach background within the exam room.

Bon Secours | Ashland Emergency Center

Bon Secours | Ashland Emergency Center | Ashland, VA

In response to a growing population and increased demand for medical imaging and emergency healthcare services, Bon Secours – Richmond partnered with DPR Construction to construct a free-standing emergency center in Ashland, Virginia. The new space features ten exam rooms, including one trauma, two behavioral health, and one individual-of-size (IOS) room, staffed by board-certified emergency department physicians and nurses, with state-of-the-art diagnostic equipment. The imaging suite includes CT, MRI, Ultrasound, and X-ray modalities.

Partners

  • Design Team GBBN Architects
  • Design Team Heapy

About The Project

DPR utilized off-site prefabrication for 67 exterior and 348 interior panels, which included sheathing, air barrier, plumbing, medical gas, electrical, and low-voltage rough-in. The prefabricated walls were constructed at DPR’s Prefabrication Assembly Facility (PAF) facility in Ashland and set onsite by DPR self-perform carpenters in seven days. This process reduced the onsite framing duration by over two months.

Additionally, DPR utilized its self-perform teams to complete drywall, ceilings, firestopping, and specialty scopes on the project, as well as the EIG team to complete the electrical scope of work.

THE Challenges

The seismic classification for the project was changed after VDC modelling was nearly complete. This modification required the BIM/VDC teams to add and re-coordinate around seismic bracing for the steel, MEP and framing systems. Since the roof slab was not designed to support any MEP loads, all bracing had to be routed back to structural steel.

The prefabrication process required precise alignment of framing, in-wall MEP systems, and millwork. Various healthcare codes and authorities regulate the locations of medical devices and other fixtures, and the VDC team must have sign-off from the design team and owner before moving devices to accommodate conflicts. All of this coordination had to be completed before the prefabricated panels were fabricated to ensure success.

View of an interior room in a medical facility showing monitoring equipment and a hospital bed
A craftsperson works on the interior of a structure showing framing and panels in the background
THE

Challenges

View of an interior room in a medical facility showing monitoring equipment and a hospital bed

The seismic classification for the project was changed after VDC modelling was nearly complete. This modification required the BIM/VDC teams to add and re-coordinate around seismic bracing for the steel, MEP and framing systems. Since the roof slab was not designed to support any MEP loads, all bracing had to be routed back to structural steel.

A craftsperson works on the interior of a structure showing framing and panels in the background

The prefabrication process required precise alignment of framing, in-wall MEP systems, and millwork. Various healthcare codes and authorities regulate the locations of medical devices and other fixtures, and the VDC team must have sign-off from the design team and owner before moving devices to accommodate conflicts. All of this coordination had to be completed before the prefabricated panels were fabricated to ensure success.

THE Solutions

The project team conducted VDC calls twice a week with trade partners, the design team, and ownership to improve collaboration and resolve conflicts as they arose. To maintain the project's critical path, the start of fabrication for the prefabricated panels could not be delayed due to the extra coordination needed. Additionally, the team adjusted the modeling process to enable priority panels to begin fabrication before the overall VDC was completed.

The team adapted its strategy by reassessing priorities with input from all stakeholders. This flexibility enabled them to meet the critical wall release timeline and to set a new, effective approach for future projects.

Exterior view of panel being installed on a building
Room in a medical facility
THE

Solutions

Exterior view of panel being installed on a building

The project team conducted VDC calls twice a week with trade partners, the design team, and ownership to improve collaboration and resolve conflicts as they arose. To maintain the project's critical path, the start of fabrication for the prefabricated panels could not be delayed due to the extra coordination needed. Additionally, the team adjusted the modeling process to enable priority panels to begin fabrication before the overall VDC was completed.

Room in a medical facility

The team adapted its strategy by reassessing priorities with input from all stakeholders. This flexibility enabled them to meet the critical wall release timeline and to set a new, effective approach for future projects.
